|
|
December 11, 2025
Cross Kirkland Corridor Trail to temporarily open as early as December 11
The CKC trail section under repair will open for approximately 2 weeks.
|
|
|
Starting as early as December 11 the Cross Kirkland Corridor (CKC) Trail between NE 52 Street and 108 Avenue NE will open to the public for approximately two weeks.
Crews were able to find a natural pause in construction to allow for the scheduled 12K's of Christmas run and for community members to safely access the trail.

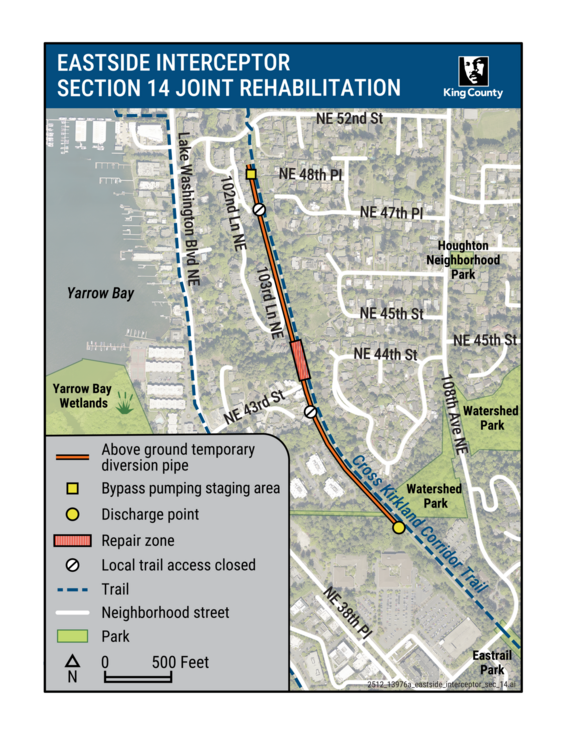

For your safety, avoid entering the trail along west trail access points (see map) and keep your distance from construction equipment and materials on the side of the trail. The temporary 3,000-foot long above-ground diversion pipe is currently along the west side of the trail and community members should stay away from the pipe.
Crews will close the trail again in approximately 2 weeks to complete repairs to the ESI 14 pipe. We will notify you in advance of the trail closing again.
|
|
About the project
The ESI 14 sewer pipe is a 7-foot diameter pipe, which carries 10 million gallons of wastewater a day on average during dry weather. In late July 2025, King County and City of Kirkland crews detected a leak from the County’s ESI 14 sewer pipe that was entering Kirkland’s piped stream. King County coordinated with Public Health – Seattle & King County, and no public health risk was identified.
In September 2025, King County Department of Natural Resources and Parks issued a Declaration of Urgency to expedite the repair efforts. The City of Kirkland also issued a Proclamation of Emergency to aid in repairs.
Since September, King County crews and contractors have been repairing the section of CKC Trail between NE 52nd Street and 108th Avenue NE. Repair work consists of installing a temporary above-ground wastewater diversion, repairing the joints inside the underground 7-foot diameter pipe, and restoring the construction site.
|
|
What you can expect
Crews installed a 3,000-foot above-ground temporary 18-inch pipe to divert the wastewater. They dug in two locations on each side of the leaking joints to connect the sewer flows to the above-ground temporary diversion pipe.
- Wastewater flows will be diverted to the above-ground pipe using a bypass pump with four generators to maintain sewer service for the community.
- While flows are diverted above-ground, crews will enter the empty 7-foot diameter underground ESI 14 pipe to repair the leaking joints.
- Once repairs are complete, crews will restore flows to the ESI 14 underground pipe, remove the above-ground temporary pipe, and restore the trail.
|
|
|
To stay informed about the project, please visit our project webpage at kingcounty.gov/wtd/kirkland-ckc
If you have any questions, please reach out to Emanuel da Silva (mano) by calling (206) 406-3058 or emailing mdasilva@kingcounty.gov.
We offer interpretation services at no cost.
|
|
