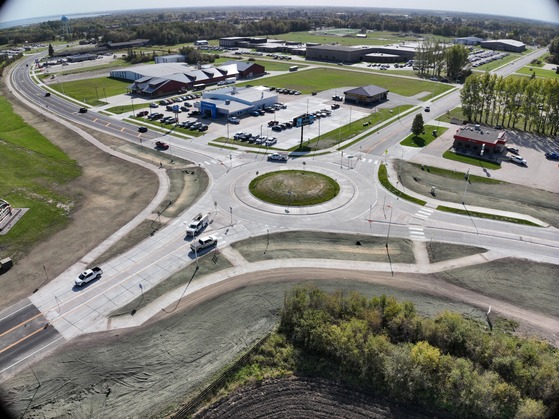

 Highway 11/313 roundabout complete. Photo taken Sept. 29.
Highway 11 Warroad Construction:
October 3
What's happening this week?
September 29-October 4
-
Traffic impacts: Truck detour in place. Single lane traffic with temporary lights at Warroad River bridge. See detour maps.
-
Bridge project –Continue setting beams, set falsework, tie rebar, prepare for deck pour
-
Roundabout project–Project complete. Crews are working on sweeping and cleanup.
What's happening next week?
October 6-11
-
Traffic impacts: Truck detour in place. Single lane traffic with temporary lights at Warroad River bridge. See detour maps.
-
Bridge project – Prepare deck for pour.
About the project:
MnDOT, in collaboration with Roseau County and the City of Warroad, plans to reconstruct Highway 11 between County Road 5 and Highway 313/Cedar Avenue NW and Cedar Avenue NW between Highway 11 and Lake Street.
Construction is scheduled to take place in 2024-2026.
These roadways are in need of long-term improvements to address aging infrastructure, safety, and access issues. This project will resurface deteriorating pavement, replace storm sewer, and incorporate landscaping along the project area.
2024: Resurface Hwy 11 south of the bridge and Cedar Ave. Begin Hwy 11/313 roundabout.
2025: Construct Highway 11/313 roundabout. Begin half of the bridge construction.
2026: Continue other half of the bridge construction.
The bridge will be constructed in 2025 and 2026. The bridge will remain open during the winter months.
How about a roundabout?
Traffic impacts:

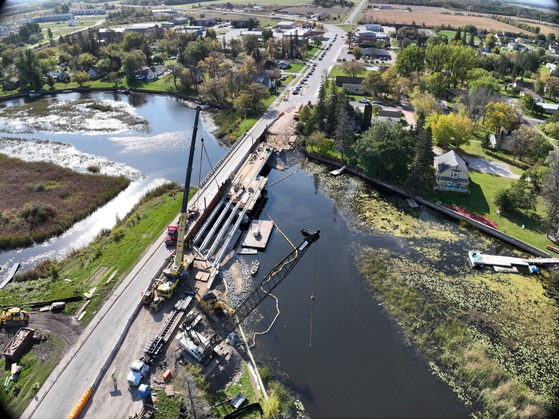

 Crews are preparing the set the beam on the north end of the bridge. Photo taken Sept. 29.

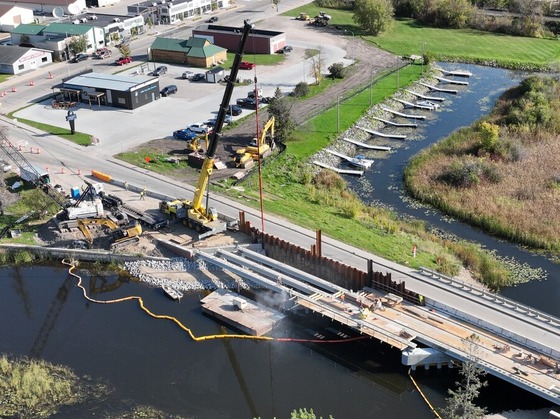

 Setting the beam on the north end of the bridge. Crews continue falsework on the south end. Photo taken Sept. 29.

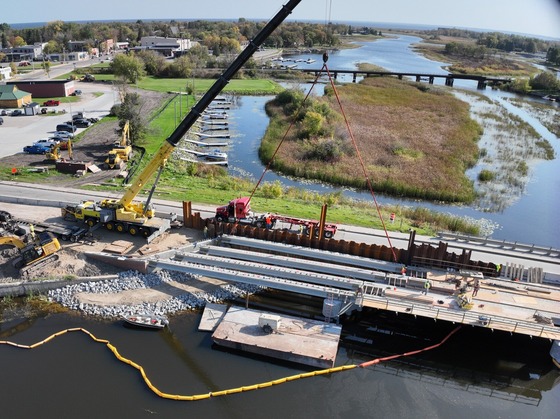

 Setting the beam on the north end of the bridge. Crews continue falsework on the south end. Photo taken Sept. 29.
  The truck detour is in place for the duration of the project.
www.511mn.org
Visit: mndot.gov/d2/projects/hwy11-warroad
|
