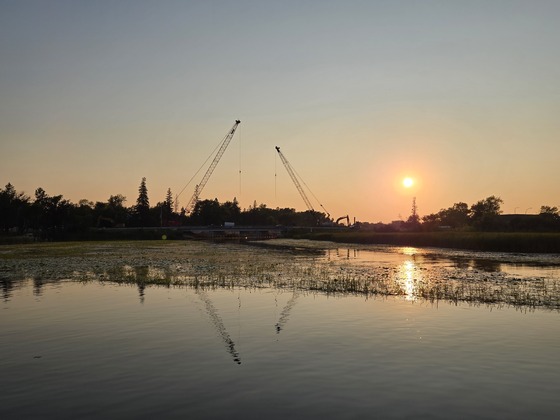

 Hwy 11 Warroad River bridge: photo provided by Warroad Chamber of Commerce
  Stage 2: Construct east, west and south legs of the roundabout. Cedar Avenue will be closed at Hwy 11 during this stage, approximately 3-4 months.
Highway 11 Warroad Construction: July 11
What's happening this week?
July 7-11
-
Traffic impacts: Traffic will remain in the configuration that it has been in. Short term access closures for concrete placement.
- Hwy 11 bridge: Sheet piling has been completed. Crews are beginning excavation to install new abutments and piles. Lod piles and pier caps will be removed.
- Hwy 11/313 roundabout: most of the concrete placement was completed. Crews are working on sawing joints and preparing for bituminous pavement.
What's happening next week?
July 14-18
-
Traffic impacts: Traffic will remain in the configuration that it has been in. Short term access closures for concrete placement and bituminous paving.
- Hwy 11 bridge: New abutment will be installed. Pile driving activities and channel excavation will begin.
- Hwy 11/313 roundabout: Bituminous paving on Cedar Ave, Hwy 11 and city streets south of the Warroad River bridge.
About the project:
MnDOT, in collaboration with Roseau County and the City of Warroad, plans to reconstruct Highway 11 between County Road 5 and Highway 313/Cedar Avenue NW and Cedar Avenue NW between Highway 11 and Lake Street.
Construction is scheduled to take place in 2024-2026.
These roadways are in need of long-term improvements to address aging infrastructure, safety, and access issues. This project will resurface deteriorating pavement, replace storm sewer, and incorporate landscaping along the project area.
2024: Resurface Hwy 11 south of the bridge and Cedar Ave. Begin Hwy 11/313 roundabout.
2025: Construct Highway 11/313 roundabout. Begin half of the bridge construction.
2026: Continue other half of the bridge construction.
The bridge will be constructed in 2025 and 2026. The bridge will remain open during the winter months.
How about a roundabout?
Traffic impacts:
 Once Stage 2 of the roundabout construction is complete, Stage 3 will begin. Stage 3: Construct north leg of the roundabout. Hwy 313 will be closed during this stage, approximately 2-3 weeks. See detour map.
 The truck detour is in place for the duration of the project. The Hwy 313 detour will only be in place during Stage 3 of the project which will take place toward the end of the project and last approximately 2-3 weeks, weather permitting.
www.511mn.org
Visit: mndot.gov/d2/projects/hwy11-warroad
|
