An Update on the Lode Lane Enhancement Scheme

Lode Lane Enhancement Scheme Update

Work continues on Solihull Council’s Lode Lane Enhancement Scheme, to establish a bus lane and shared use footway/cycleway from Dovehouse Lane to Warwick Road.


The Council would like to thank residents and motorists for their continued patience while these important infrastructure works are carried out.


What's happening at the moment?

Lode Lane - new entrance to Solihull Hospital

Two new sections of bus lane to open

All work is now complete in Segment C and Segment D (which covers the area from Solihull Bypass to Warwick Road).



This means that from Friday 10 June two sections of new bus lane on Lode Lane will open.


The two stretches of bus lane, in the direction of Solihull town centre only (southbound), are located between the canal bridge and the junction with Rowood Drive and between the junction with Grove Road and Poplar Road.

Bus Lane



The bus lanes will be indicated by a thick white line on the road and will be in operation 24 hours a day. Other vehicles permitted to use the lane are licensed taxis, bicycles and motorcycles.



Signs will be in place along the route to advise drivers of the changes. Motorists found to be using the bus lane when not permitted face being issued with a Penalty Charge Notice (PCN) and are reminded that this can delay buses and cause congestion.

The final stretch of new bus lane on Lode Lane, between Moat Lane and Hermitage Road, is due to be opened following the completion of the second phase of the scheme in autumn 2016.

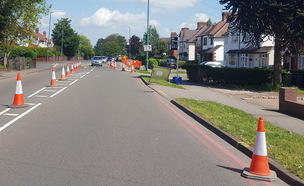

Lode Lane - Work in Segment B

Segment B – Rowood Drive to Solihull Bypass

Recently a new kerbline from Boulton Road to Moat Lane has been installed, and work focussed on the area from Moat Lane to the park on Hermitage Road. BT are currently undertaking a utility diversion in this area


Work will now move to Severn Star Road where the existing junction will be upgraded to a toucan crossing.


Segment A - Dovehouse Lane to Rowood Drive

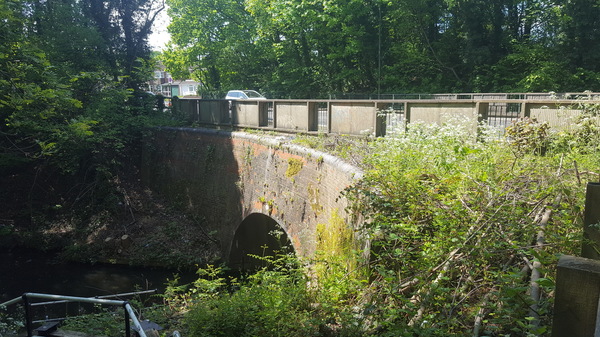

The canal bridge on Lode Lane

Canal bridge repairs

During recent waterproofing of the canal bridge on Lode Lane, a number of structural defects were discovered. It is therefore necessary to carry out further repairs to the bridge. This work will begin in early July and involves strengthening of the bridge from above as well as repair of a bridge beam from below. It is expected that this work will take 8 weeks to complete. The bridge does not pose a danger to the travelling public.



Due to the extent of the work area it will be necessary to close one lane across the bridge. To keep traffic flowing, one lane will remain open at all times and temporary 24-hour traffic lights will be in operation. Signage will be installed prior to the works starting to inform drivers of the expected delays throughout the work period.



This necessary and unavoidable repair work will lead to long delays (expected to be as high as 20-30 minutes) and significant congestion along Lode Lane, particularly during the morning and afternoon peak periods.



To ensure as little disruption as possible is caused by these works, they have been scheduled to take place predominantly during the school summer holidays and during Jaguar Lane Rover's shut down period. The Council’s contractor Balfour Beatty will be working double-shifts. This is to ensure the duration of the works is kept to a minimum whilst still maintaining safe working practices, and that any noisy activities are not carried out at night.



New trees on Lode Lane

This work was not originally scheduled to be carried out as part of the current scheme to enhance Lode Lane. However due to the necessity of the repairs and to avoid further inconvenience by returning at a future date; the work has been incorporated into the existing scheme.


Replacement of Trees

The Council is currently in the process of replacing trees which have needed to be removed along Lode Lane as part of this scheme. Wherever possible, these trees will be placed on or near to their previous locations.
