|
 Current traffic impacts
-

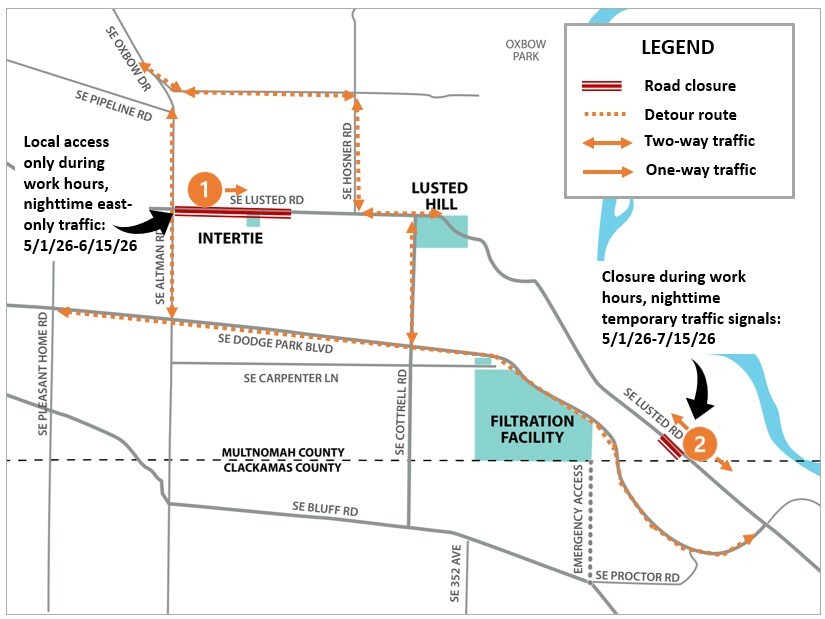

Lusted Road (between Altman Road and west of Hosner Road) through June 15, 2026: Local access only closure with one-way eastbound traffic outside work hours. Through traffic will be detoured to Altman Road or Hosner Road. Residents within the work zone on Lusted Road will have access from the west.
-
Lusted Road (just north of county line) through July 15, 2026: Closure during work hours with two-way traffic managed by temporary traffic signals outside work hours. During work hours, residents will be able to travel either north or south of the closure. Through traffic will be detoured to Dodge Park Boulevard and Cottrell Road. Access for school buses and emergency vehicles will be maintained.
Controlled blasts during pipeline shaft excavation
Our contractors are using some controlled blasts during excavation of the pipeline shaft in the southeast corner of the filtration facility site. The controlled blasts will be used inside the shaft to help the excavation equipment get through a layer of Boring lava deep underground.
Controlled blasts will be scheduled on week days between the hours of 9 a.m. and 4 p.m. The activity may be spaced over several weeks. Safety will be a priority throughout. The noise and vibration from each blast will last a few seconds and will be monitored.
Scheduled activities:
- April 28, 2026 (complete)
- May 7, 2026 between 9 a.m.-4 p.m.
Project neighbors can sign up for pre-blast notices at portland.gov/brtpnews.
Other work happening the week of May 4
Staff will be at the project work sites during shift hours to perform various tasks. Work hours will be between 7 a.m. and 6 p.m., Monday through Saturday.
Filtration facility site activities include:
- Ongoing construction traffic traveling to and from the site, including increased concrete truck traffic and bussing and vanpooling for craftworkers
- Delivering equipment and materials to the site
- Pouring concrete for treatment process areas and buildings
- Installing new water pipeline at the site
- Excavating raw water pipeline shaft at southeast corner of facility site
- Ongoing stormwater management and erosion control
- Lighting for safety and maintenance activities
- As needed street sweeping
Raw water tunnel/pipeline site activities include:
- Excavating two pipeline tunnels
- Installing new water pipeline under Lusted Road, work includes equipment behind closure barriers
- Ongoing stormwater management and erosion control
- Noise and vibration through June
Finished water pipeline site activities include:
- Delivering equipment and materials to the work sites
- Installing new water pipeline along north side of Lusted Road between Altman Road and intertie site
- Preparing for temporary paving on Lusted Road (Altman Road to intertie site) after pipe installation
- Ongoing stormwater management and erosion control
- As needed street sweeping
Finished water intertie site activities include:
Work schedules are subject to change depending on weather and other field conditions. For the latest, please visit: portland.gov/filtrationconstruction.
Upcoming traffic impacts
Please note that some planned traffic restrictions are pending county approval.
- Altman Road (between Oxbow Drive and Lusted Road) local access only closure during work hours with one-way traffic outside work hours—estimated mid-July 2026-March 2027
- Dodge Park Boulevard (between Altman Road and Cottrell Road) single-lane restriction with flagging during work hours—estimated mid-July 2026-March 2027
Bull Run Filtration: coffee with the contractor
The Water Bureau will host an informal drop-in session where Bull Run Filtration Project neighbors can chat with representatives of the facility and pipeline construction teams, ask questions, and hear about recent progress and upcoming work. There is no presentation, so stop in anytime between 9 and 10:30 a.m.
Date: Thursday, May 14, 2026
Time: 9 to 10:30 a.m. (drop in)
Where: Multnomah County Grange #71, 30639 SE Bluff Road, Gresham
Can't make it this time? Join us at the next Coffee with the Contractor event June 11, 2026.
|
|
Get construction text alerts
Sign up to receive text notifications about temporary lane closures and other construction traffic information related to the Bull Run Filtration project.
|
|
|
The Bull Run Filtration Project will remove Cryptosporidium and other contaminants from the Bull Run water supply, producing cleaner, safer water for the one million people who use our water now and for future generations. The project is required by the federal Safe Drinking Water Act and must be in operation by September 30, 2027, through a bilateral compliance agreement with the Oregon Health Authority.
To learn more, visit portland.gov/water/filtration.
|
|
|
