U.S. 20 Corvallis-Newport Highway construction update

U.S. 20 Corvallis-Newport

Highway construction Update - Fall 2017

Slide Repair Information



October 26, 2017

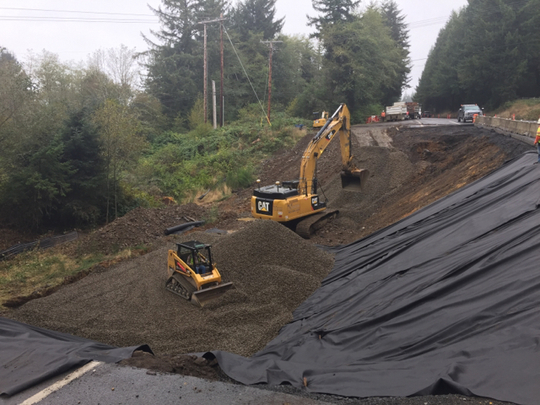

Slide repair site on U.S. 20 at milepost 2.25construction blocks used to stabilize the slope

Slide Repair Milepost 2.25

Construction to repair the slide on U.S. 20 at milepost 2.25 began several weeks ago and will continue until December 16. Traffic will be flagged 24 hours a day at the site until the project is complete for the protection of work crews and travelers through the construction area.



Background

Slides are known to have occurred around milepost 2.25 since the 1950s. In the 1960s a culvert was placed under the roadway to move water away and the slope became relatively stable with small repairs needed occasionally. In winter 2015 a bigger slide occurred. This closed one lane at the site until repairs were made in fall 2016. These repairs were made based on what was known about the site at the time and the maintenance funds available. Unfortunately the fix did not hold. Record rainfall began immediately after the repairs were complete and a larger slide occurred in late November.

A deeper investigation into the site found a large historic slide that continues to the bay below. It also found that the culvert had failed, pooling water under the roadway.



The Fix

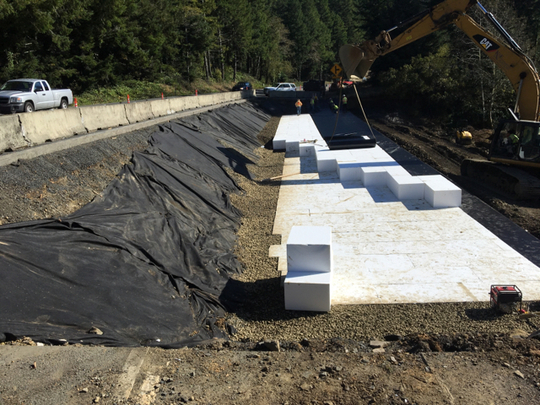

To actually fix the roadway, we’re working to move water and take some weight off of the slide area. You may have seen these large white blocks alongside the road. They looked like styrofoam and they basically are. They are a lightweight material that weighs about 2 pounds per cubic foot that will replace soil and rock that weighs 120 to 140 pounds per cubic foot, which will effectively unload weight from the landslide. They have been put in place a few feet below the road surface over the last week.  They will be covered with rock and the road will be repaved.

We’re also installing a new culvert and a deep drain that will lower the groundwater and move the water away from the slope, which should help keep the road in good shape.

Last year’s repair cost about $100,000. This project is expected to cost about $1 million.



Travel

U.S. 20 is a well-travelled route with many people commuting daily between Newport and Corvallis for work, school, and appointments.  During periods when traffic is very heavy in both directions, 100 vehicles are released in each direction at a time, which behaved much like a traffic signal.  At times when traffic is heavy in only one direction, 100 vehicles are released from the heavy direction and then the light direction is cleared, which typically doesn’t take as much time and the vehicle count is less than 100.  Once the light direction is cleared, 100 vehicles are immediately release from the heavy direction.  Different scenarios have been tried at this location, and the current plan has worked the best.  Unfortunately, the roadway is too narrow to perform the necessary construction and keep more than one lane open.

Other U.S. 20 projects

Pioneer Mountain – Eddyville: The entire new road is now open. The west end curve was completed and opened on schedule earlier this fall. Final work continues in a few areas, but little traffic impact is expected.

Clem Road – Philomath Paving: Paving is done, but the finish work of placing signs and delineators continues. Work is being done both day and night. Flagging and pilot cars may be necessary.

Next year…..

We are going to give travelers a year off to enjoy the recent improvements.

 In 2019, there will be a culvert replacement and repair project just east of the eastern Toledo exit on U.S. 20.  The project will replace failing culverts in another location plagued by landslides in an effort to redirect the water away from a landslide.  Plan details are still being worked out.

A project funded in the recent transportation bill that will repave U.S. 20 through Philomath as a joint effort between ODOT and the City of Philomath.  Although the project isn’t designed yet and schedules are still being worked out, the current plan is to put the project out for bid in 2019.
