 We have updated our construction map for the METRO E Line. You can find it at the top of our project web page.
Dates are approximate and subject to change. As the construction season continues, crews may begin Saturday work at specific locations to maintain the overall project schedule. Future newsletter updates will include details where known.
Week of July 14:
- Crews will work on underground utilities.

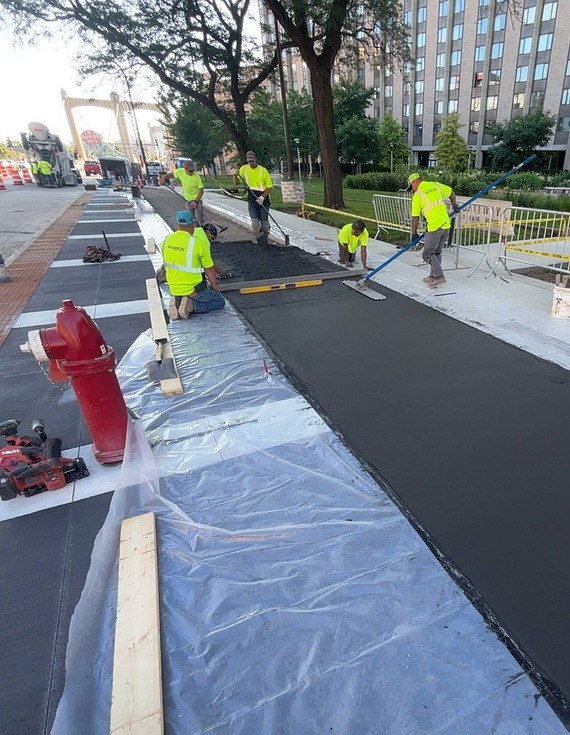

- Crews will grade surfaces and construct curb, gutter, and roadway surfaces.
Week of July 21:
- Crews will construct roadway surfaces.
- Crews will work on underground utilities.

Week of July 14:
- Crews will work on underground utilities.
- Crews will grade surfaces and construct curb and gutter.
Week of July 21:
- Crews will grade surfaces and construct curb, gutter, and roadway surfaces.
Week of July 14:
- Crews will work on underground utilities.
- Crews will grade surfaces and construct sidewalks.
Week of July 21:
- Crews will grade surfaces and construct sidewalks.
Week of July 14:
- Crews will continue to construct sidewalks.
- Crews will stripe the roadway and erect signage.
- Following the completion of civil construction, work is focused on installation of lighting and E Line platform amenities. We will update this section when we have timelines for this work.
Week of July 14:
- Crews will work on sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of July 21:
- Crews will work on underground utilities.
Week of July 14:
- Crews will be working on both sides of the intersection.
- Crews will construct sidewalks, bike lanes, curbs, gutters, and roadway surfaces.
- Crews will stripe and install signage on the east side of the intersection.
Week of July 21:
- Crews will construct roadway surfaces.
- Crews will work on underground utilities.
Week of July 14:
- Crews will construct sidewalks and bike lanes.
Week of July 21:
- Crews will stripe roadways and erect signage before removing traffic control.
Week of July 14:
- Crews will sign and stripe the area before removing traffic control.
- Following the completion of civil construction, work is focused on installation of lighting and E Line platform amenities. We will update this section when we have timelines for this work.
Week of July 14:
- Crews will work on underground utilities.
Week of July 21:
- Crews will work on underground utilities.
- Crews will grade soil in preparation for pouring concrete.
- Crews will construct curb and gutter.
|
|
|
Final completion of stations will occur this year as Metro Transit prepares for the launch of E Line service. After civil construction of station platforms is complete, installation of station amenities (including shelters, real-time signs, bike racks, and benches) and equipment testing will occur. These activities are expected to take only a few days at each site and will cause minimal disruption to traffic.
Platform construction will also be completed at several stations through coordinated projects with Metro Transit’s partners including:
In addition to stations, E Line construction activities also include installation of fiber optic communication infrastructure and construction of additional pedestrian, traffic signal, bikeway, and intersection improvements delivered in partnership with Hennepin County and the City of Minneapolis.
- Work in the corridor includes station construction, utility work, pavement and intersection improvements, and traffic signal changes.
- Expect temporary lane restrictions and marked detours for traffic.
- Pedestrian access will remain for businesses and residences.
- Buses will experience detours during construction. Up-to-date information about bus detours and temporary stop locations can be found at metrotransit.org/alerts and by subscription to Rider Alerts.
- Construction will be staged at each station intersection to allow for vehicular traffic flow.
Businesses will remain open during construction, and you can get to know more about local businesses and how to access them during construction through our newsletter! If you would like to have your business featured, email us here.
Any questions about construction can be directed to our construction hotline at 612-524-6050 or to the project email at ELine@metrotransit.org.
More information on the E Line project can be found on the project website.
METRO E Line staff will hold office hours at:
Jones Coffee – Linden Hills 2814 W. 43rd Street, Minneapolis Wednesday, July 16, noon – 2 p.m.
Stop by to ask questions about the E Line project!
|
|
|
|
