We have updated our construction map for the METRO E Line. You can find it at the top of our project web page.
Dates are approximate and subject to change.
Week of May 19:
- Crews will work on underground utilities.
- Crews will begin sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 26:
- Crews will work on underground utilities.
Week of May 19:

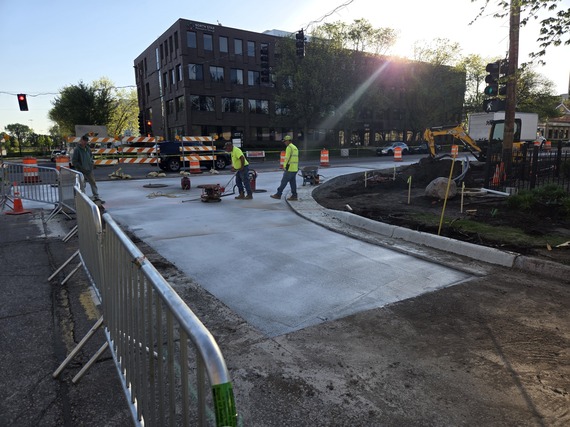

- Crews will construct sidewalks and roadway surfaces.
- Crews will work on underground utilities.
- Crews will continue sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 26:
- Crews will construct roadway surfaces.
- Streets will be striped.
- Crews will shift traffic control to the north side of the intersection.
- Crews will continue sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 19:
- Crews will grade surfaces in preparation for concrete work.
- Crews will construct sidewalks and roadway surfaces.
Week of May 26:
- Crews will continue to construct sidewalks.
- Crews will stripe the intersection.
Week of May 19:
- Crews will work on underground utilities.
- Crews will continue sawcutting, removal of concrete, and grading surfaces in preparation for concrete work.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 26:
- Crews will construct sidewalks and roadway surfaces.
Week of May 19:
- Crews will construct new curb and roadway surfaces.
Week of May 26:
- Crews will construct roadway surfaces.
Week of May 19:
- Crews will work to grade surfaces in preparation for concrete work.
- Crews will construct new curb and roadway surfaces.
Week of May 26:
- Crews will construct new roadway surfaces.
- Crews will work on underground utilities.
 *Please note: The image above is a bicycle detour.
Week of May 26:
- Crews will begin underground utility work.
- Crews will begin sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 19:
- Crews will continue to work on underground utilities.
- Crews will construct sidewalks and roadway surfaces.
Week of May 26:
- Crews will begin working on the east side of Hennepin Avenue.
- Crews will continue to work on underground utilities.
- Crews will begin sawcutting and removal of concrete.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
Week of May 19:
- Crews will continue sawcutting and removal of concrete on the south side of Richfield Road.
- This work includes the use of heavy machinery, and impacts such as vibrations, loud noise, and dust and debris are to be expected.
- Crews will work on underground utilities.
- Crews will continue to grade surfaces in preparation for concrete work.
Week of May 26:
- Crews will work on underground utilities.
- Crews will construct new curb and roadway surfaces.
Week of May 19:
- Crews will continue to work on underground utilities.
- Crews will grade surfaces in preparation for concrete work.
Week of May 26:
- Crews will construct new curb and roadway surfaces.
Following the completion of civil construction, work is focused on installation of lighting and E Line platform amenities. We will update this section when we have timelines for this work.
Note: The City of Edina is currently constructing sidewalks along the east side of France Avenue between 60th and 62nd streets. This is not METRO E Line work. To learn more about this project or if you have a concern, please reach out to Chad Millner at the City of Edina.
Week of May 19:
- The southbound detour will remain in place for one week for sign installation, site restoration, and street sweeping, and to allow for shelter installation on the east side of France Avenue. This will avoid the need for an additional closure later in the construction season.
- Following the completion of civil construction, work will be focused on installation of E Line platform amenities. We will update this section when we have timelines for this work.
Note: The City of Edina is currently reconstructing 65th Street east of Drew Avenue. This is not METRO E Line work. To learn more about this project or if you have a concern, please see the City’s project website.
- Access to Southdale Hospital and Southdale Medical Center parking lots and garages will be maintained during construction.
- France Avenue can be accessed from the Hospital and Medical Center by taking Drew Avenue to 66th Street.
Week of May 19:
- Crews will continue to work on underground utilities.
- Crews will grade and construct sidewalk and roadway surfaces, including the parking lot entrance on the south side of west 65th Street.
Week of May 26:
- Crews will grade and construct sidewalk and roadway surfaces, including the parking lot entrance on the south side of west 65th Street.
|
|
|
Final completion of stations will occur this year as Metro Transit prepares for the launch of E Line service. After civil construction of station platforms is complete, installation of station amenities (including shelters, real-time signs, bike racks, and benches) and equipment testing will occur. These activities are expected to take only a few days at each site and will cause minimal disruption to traffic.
Platform construction will also be completed at several stations through coordinated projects with Metro Transit’s partners including:
In addition to stations, E Line construction activities also include installation of fiber optic communication infrastructure and construction of additional pedestrian, traffic signal, bikeway, and intersection improvements delivered in partnership with Hennepin County and the City of Minneapolis.
- Work in the corridor includes station construction, utility work, pavement and intersection improvements, and traffic signal changes.
- Expect temporary lane restrictions and marked detours for traffic.
- Pedestrian access will remain for businesses and residences.
- Buses will experience detours during construction. Up-to-date information about bus detours and temporary stop locations can be found at metrotransit.org/alerts and by subscription to Rider Alerts.
- Construction will be staged at each station intersection to allow for vehicular traffic flow.
Businesses will remain open during construction, and you can get to know more about local businesses and how to access them during construction through our newsletter! If you would like to have your business featured, email us here.
Any questions about construction can be directed to our construction hotline at 612-524-6050 or to the project email at ELine@metrotransit.org.
More information on the E Line project can be found on the project website.
METRO E Line staff will hold office hours at:
Jones Coffee – Linden Hills 2814 West 43rd Street, Minneapolis Wednesday, May 21, noon - 2 p.m.
